How Clixlogix replaced emails, spreadsheets, and phone tag with an Odoo booking system for a multi facility music studio network across the U.S. and U.K., cutting booking confirmation time 66% and scheduling conflicts 92%.

Clixlogix built an Odoo booking system on Odoo 17 Enterprise for a multi facility music studio network operating across the U.S. and U.K., unifying calendars, staff assignment, equipment availability, and billing into a single workflow. Within 90 days, booking confirmation time dropped 66%, scheduling conflicts fell 92%, off peak utilization rose 31%, and invoice cycle time improved 58%. Portal self service adoption reached 60% of all bookings by week six, and the first month end close under the new system finished two days ahead of baseline.
The client is a music studio network operating across the United States and the United Kingdom, comparable in operational profile to Abbey Road Institute or Capitol Studios. It runs five recording and post production facilities across three cities (New York, Nashville, and London), managing approximately 250 to 300 room bookings per month across recording, mixing, mastering, and film score projects, including film soundtracks and label sessions.
The network relied on emails, phone calls, and spreadsheets to coordinate rooms, engineers, and projects. Manual scheduling, double bookings, and delayed invoicing slowed throughput and distorted cash flow. Stakeholder interviews surfaced several recurring operational issues:

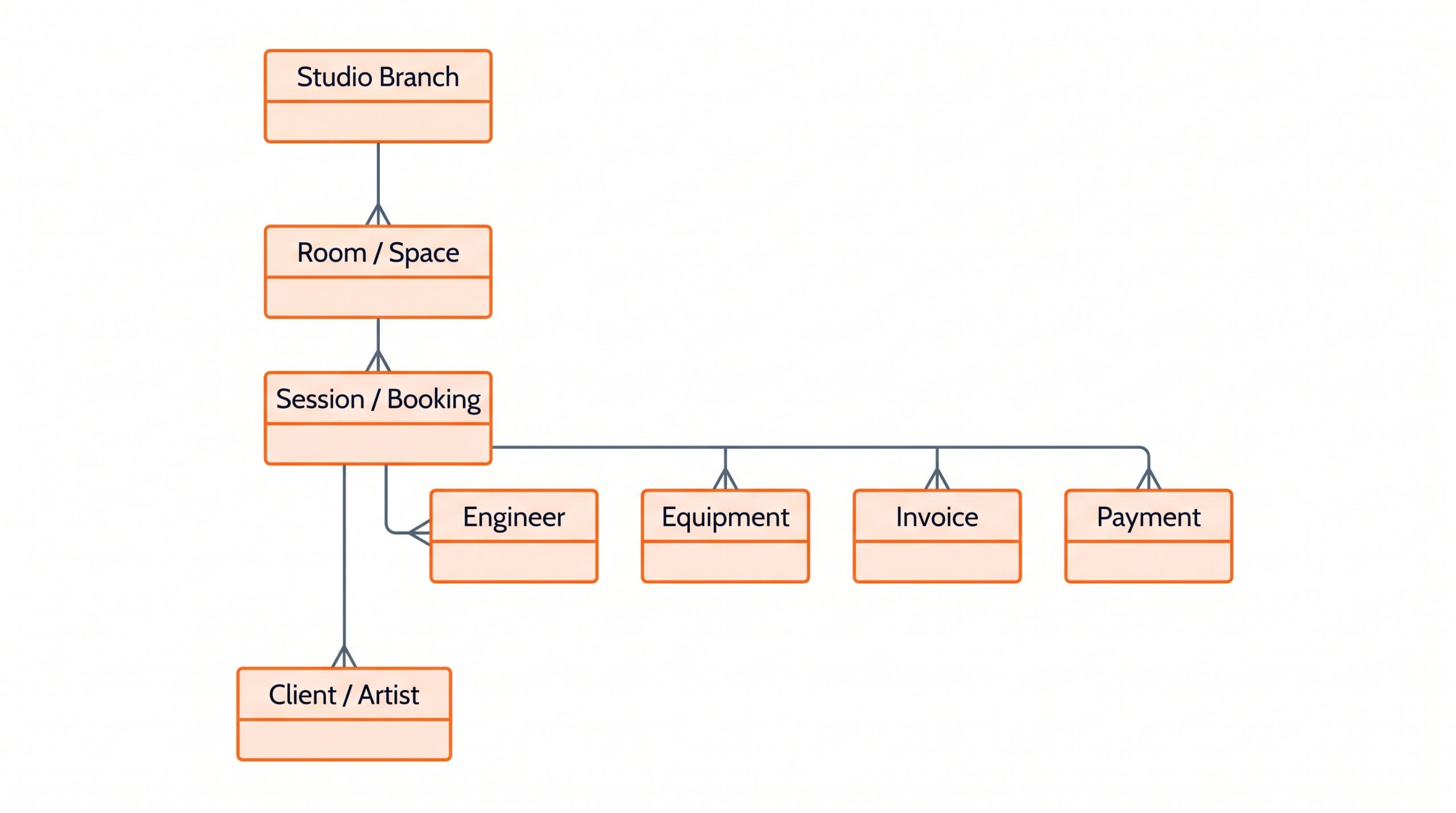

Fig 1 — Studio Network Domain Model
The client’s operations spanned multiple facilities but lacked a single system of record. Room availability, engineer schedules, and gear readiness lived in different tools. Bookings arrived by email, approvals happened over text, and finance confirmed revenue in spreadsheets. Conflicts emerged when rooms appeared free but engineers or critical microphones already had commitments elsewhere. Off peak slots went unused because discounting followed no consistent logic and resisted auditing. The disconnect directly impacted throughput: hours of rentable capacity disappeared weekly, while finance spent days reconciling deposits, cancellations, and overtime.
From a technical view, the stack offered no connective tissue. The website captured inquiries but never synced to CRM data. Booking details had no linkage to accounting, so staff reentered invoices and deposits manually. Maintenance logs existed as Google Sheets detached from scheduling, so equipment outages collided with paid sessions. Reporting required exporting CSVs and stitching together metrics from different studios, and leadership lacked visibility into utilization or engineer load. The network needed a consolidated, auditable platform that enforced booking dependencies, generated invoices automatically, and offered artists a modern self service portal.
Clixlogix deployed an Odoo 17 Enterprise platform hosted on Odoo.sh, replacing fragmented workflows with an integrated booking and operations system. The project covered discovery, design, configuration, customization, migration, and hypercare.
Early workshops surfaced the operational choke points. One session mapped a typical day: a soundtrack mix in Studio A running long while a label artist waited in Studio B, both requiring the same mastering engineer. The exercise clarified a rule: the system must confirm a booking only when room, engineer, and equipment availability intersected. Anything less would remain a provisional hold.
The final architecture enforced that constraint model. Artists used a branded portal built on Odoo Website to view rooms, rates, and add ons, see real time availability, and reserve slots with deposits. Odoo Appointments governed room calendars, while Inventory and Maintenance tracked gear and service windows. HR, Project, and Timesheets captured engineer schedules and skills. Sales and Accounting generated invoices and processed payments through Stripe. Calendar sync with external tools remained read only to prevent race conditions identified during discovery.

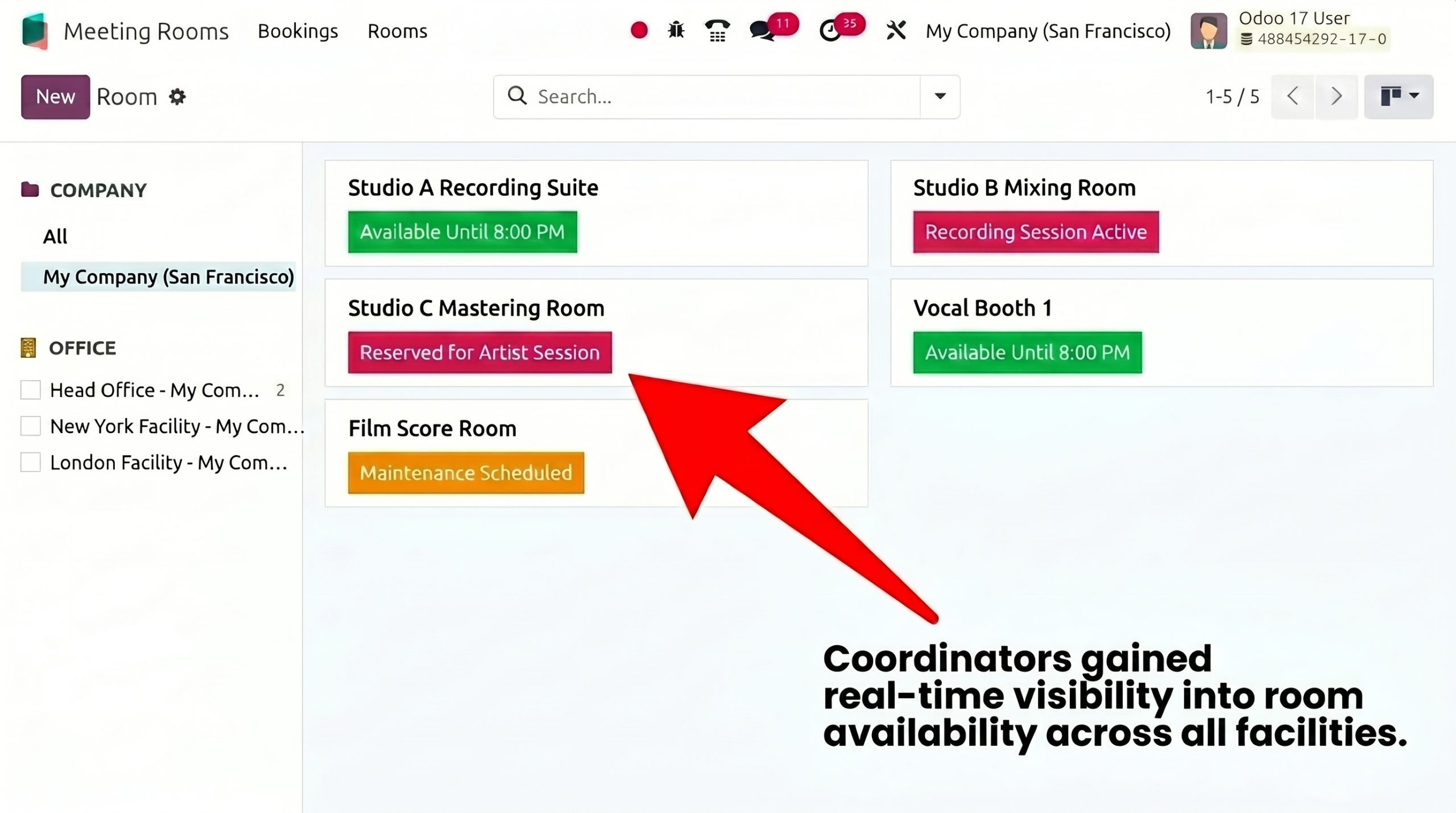

Coordinators gained a single screen showing real time status for every room across all locations: available, in session, reserved, or under maintenance. The left sidebar filters by facility (New York, Nashville, London), replacing the manual cross checking that previously required phone calls and separate calendars.

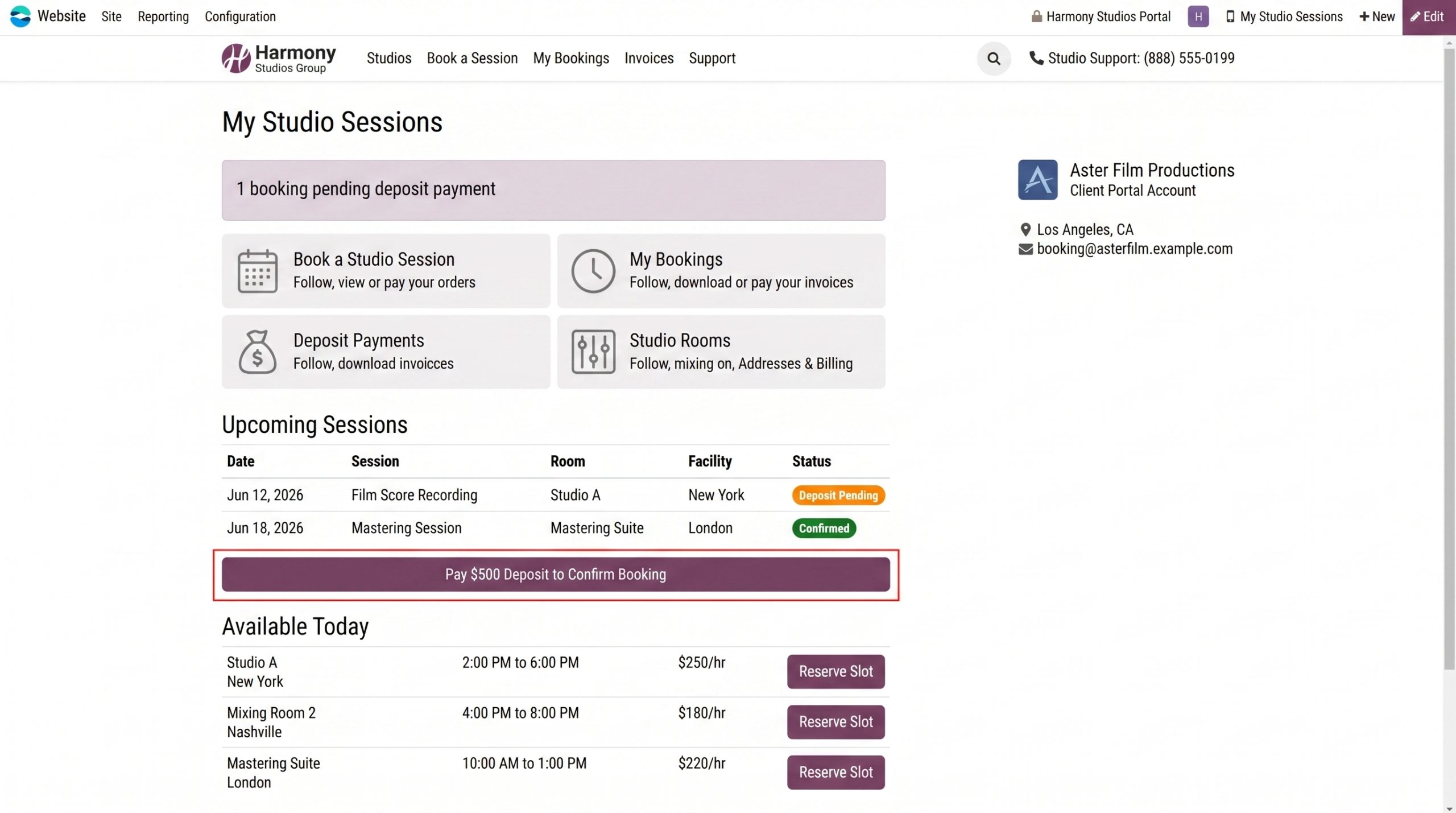

The branded portal gives artists a single view of upcoming sessions with status badges (Deposit Pending, Confirmed), a deposit payment action, and real time availability across all facilities with Reserve Slot actions. This portal drove adoption from 28% of bookings in week one to 60% by week six.

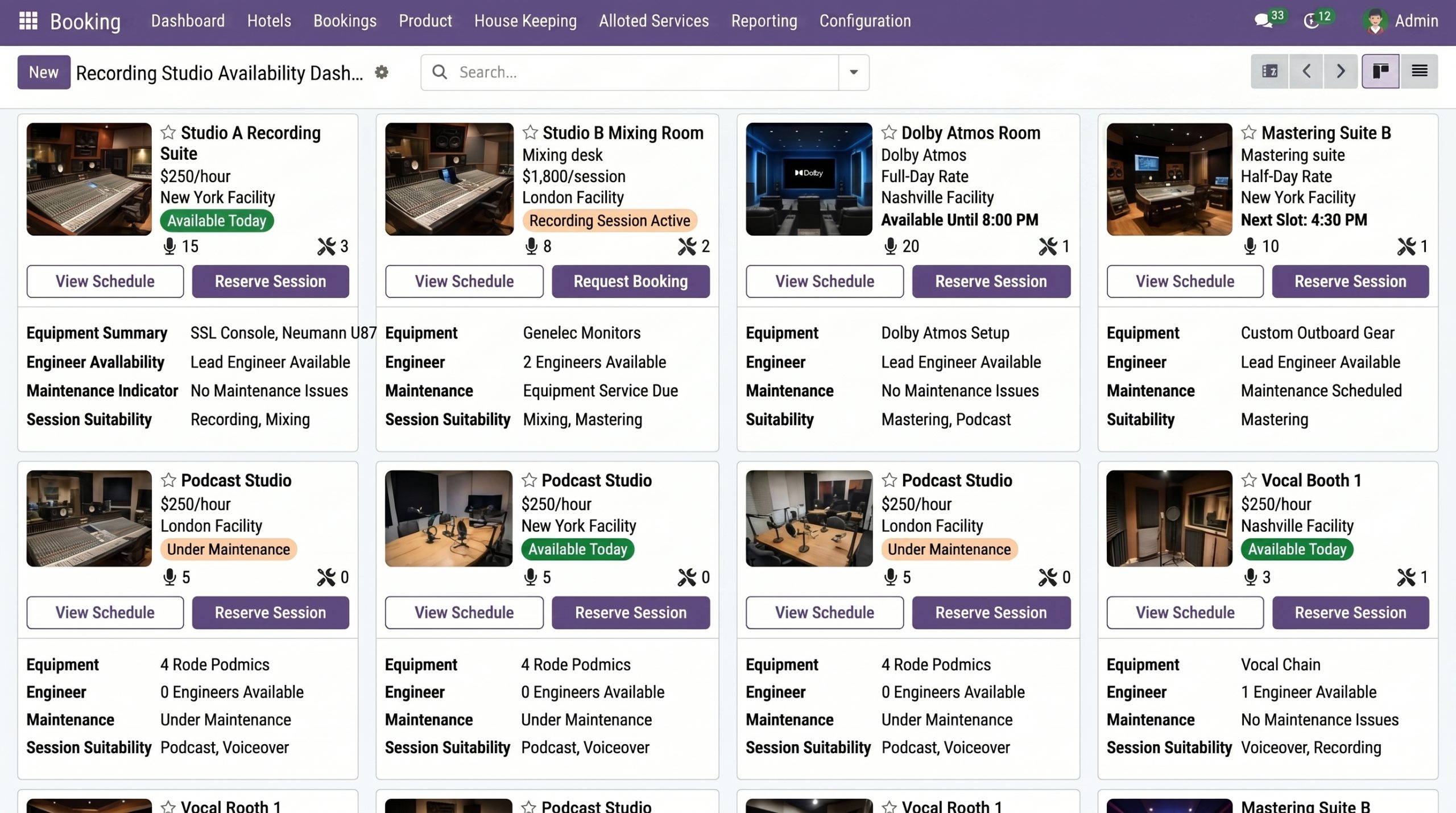

Each room card displays hourly rate, facility location, availability status, equipment summary, engineer availability, maintenance indicator, and session suitability. The constraint intersection of room, engineer, equipment, and maintenance is visible on every card.

Coordinators gained a single screen showing real time status for every room across all locations: available, in session, reserved, or under maintenance. The left sidebar filters by facility (New York, Nashville, London), replacing the manual cross checking that previously required phone calls and separate calendars.

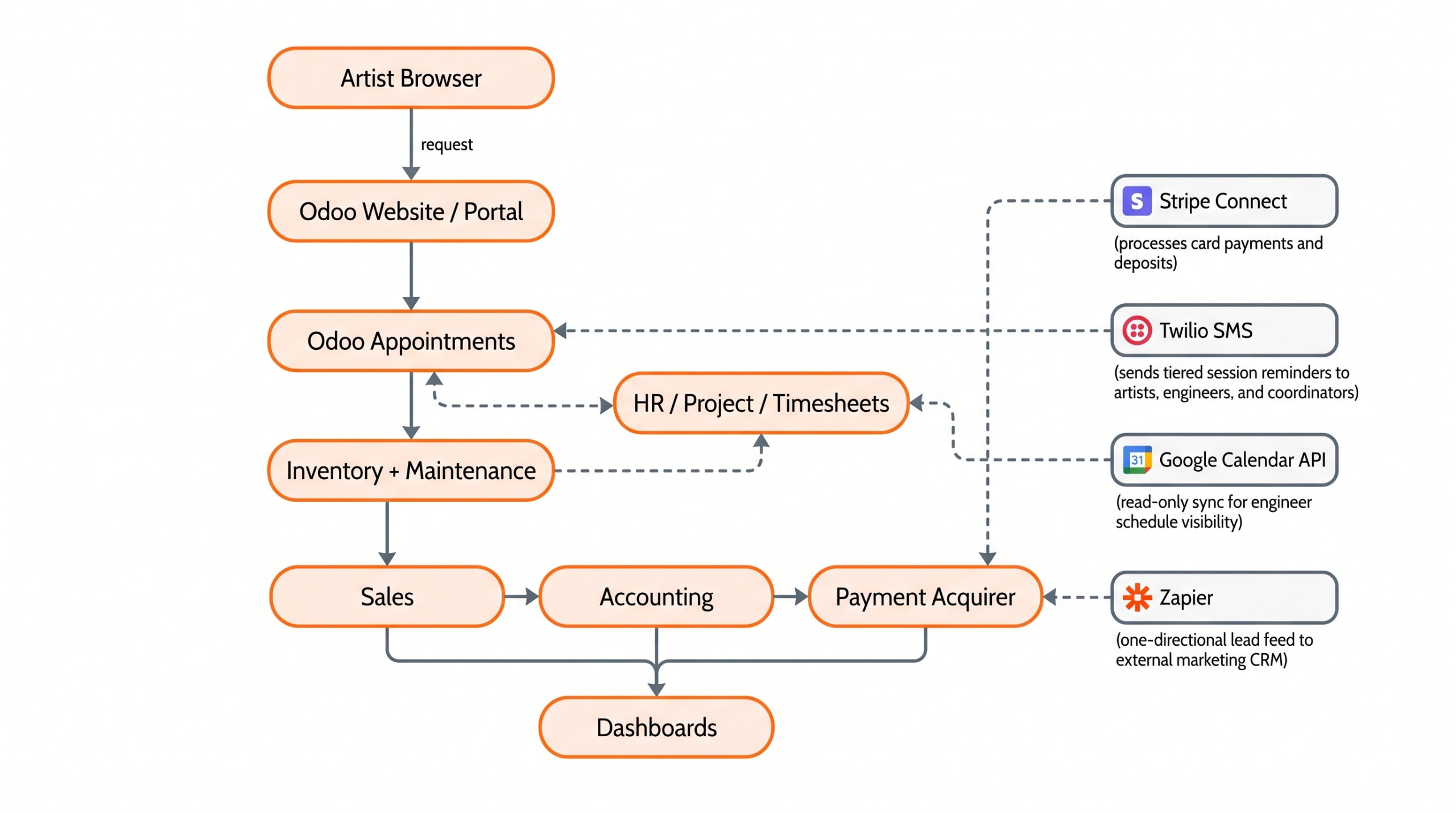

Fig 2 — Odoo Platform Architecture
Configuration extended well beyond standard module setup. Clixlogix leveraged Odoo Studio to introduce custom booking models, dependency validation scripts, and workflow automations across Appointments and Rentals. Multi company configuration reflected each studio branch as a separate company with a shared chart of accounts. The team aligned accounting workflows using multi journal management for accurate cross site reporting across the U.S. and U.K. branches.

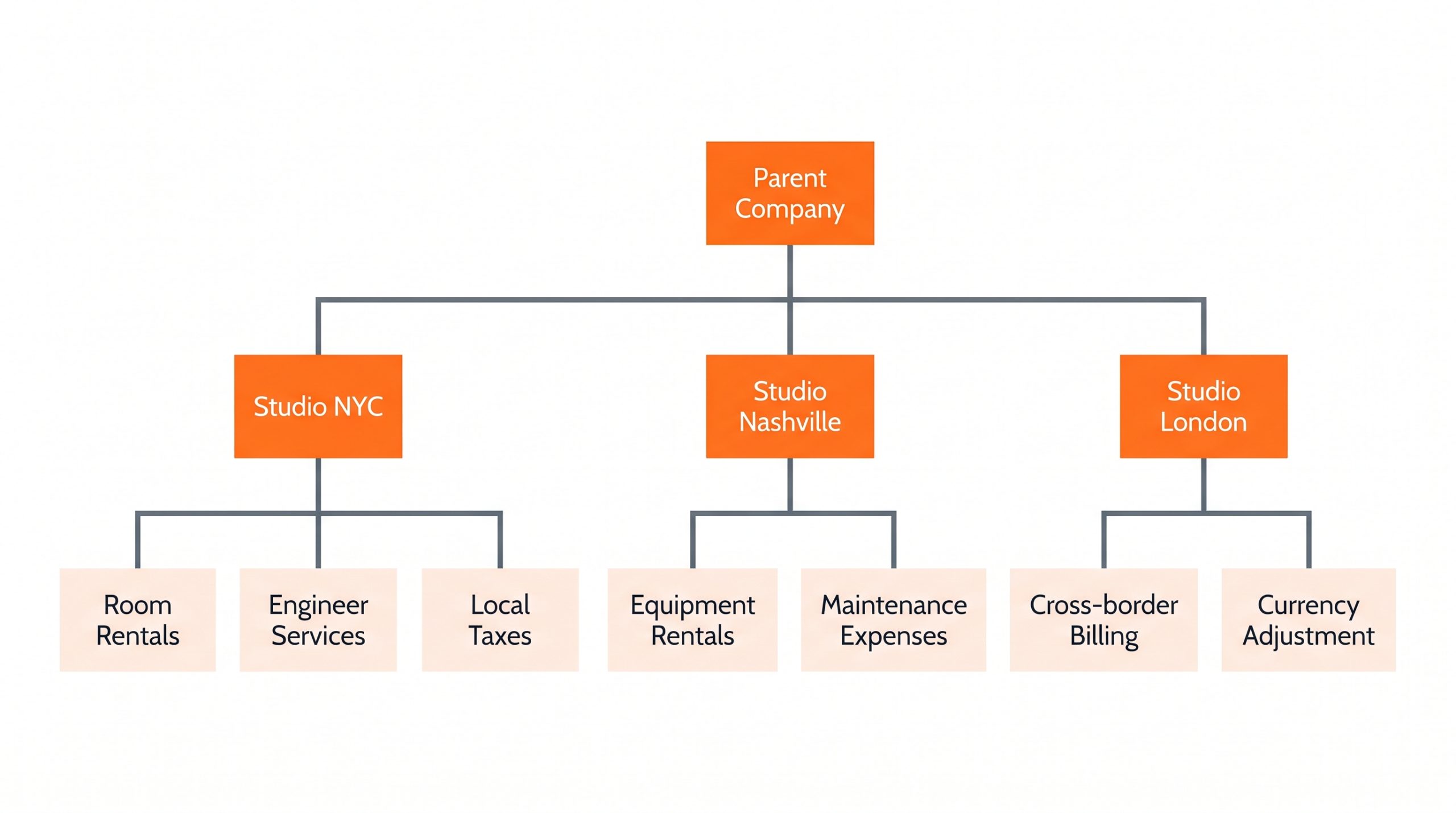

Fig 3 — Multi Company Accounting Structure

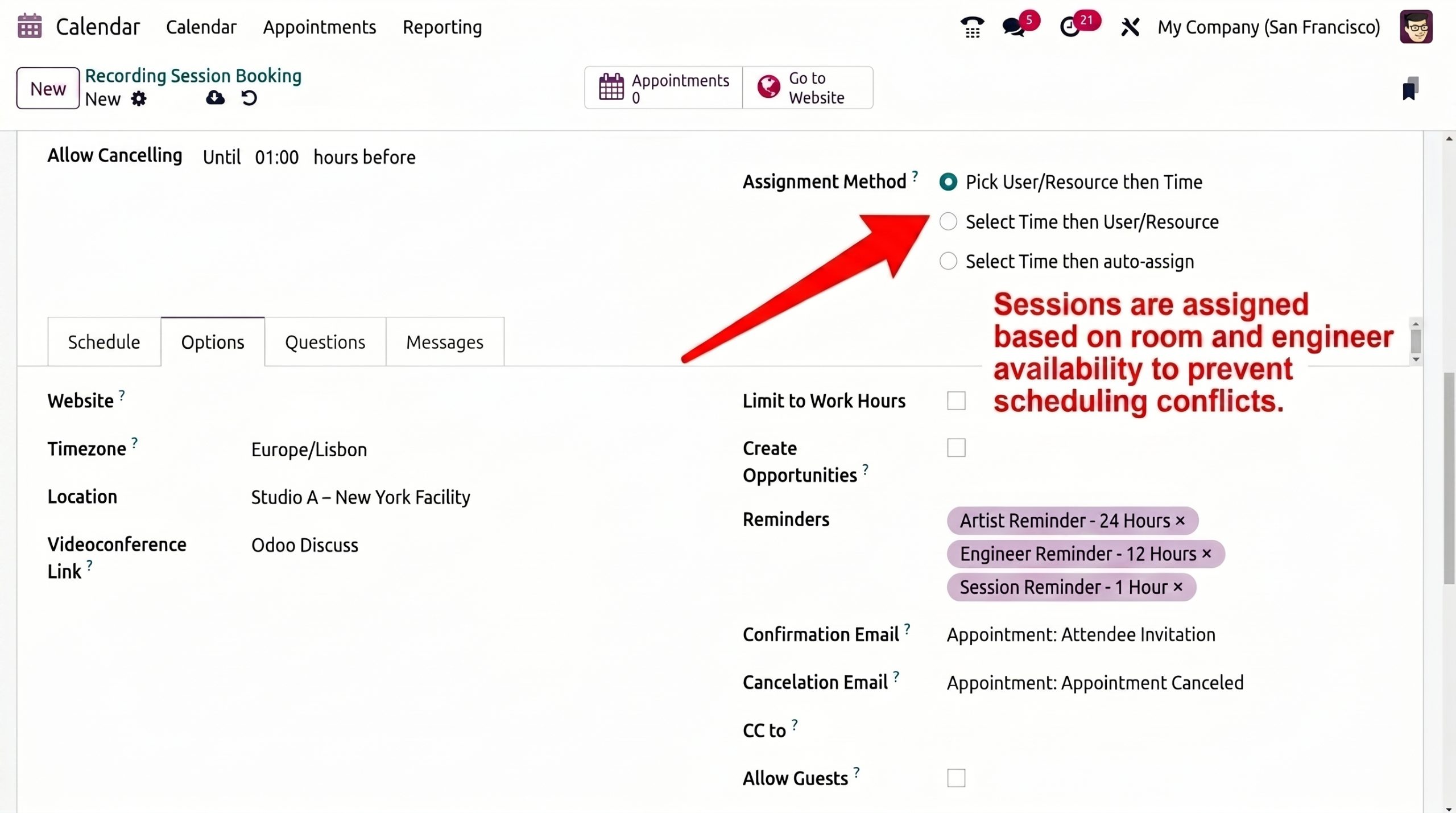

The assignment method enforces resource first booking: coordinators select the engineer and room before choosing a time slot, preventing scheduling conflicts at the point of entry. Tiered reminders (artist at 24 hours, engineer at 12 hours, session at 1 hour) reduced no shows and late arrivals across all facilities.

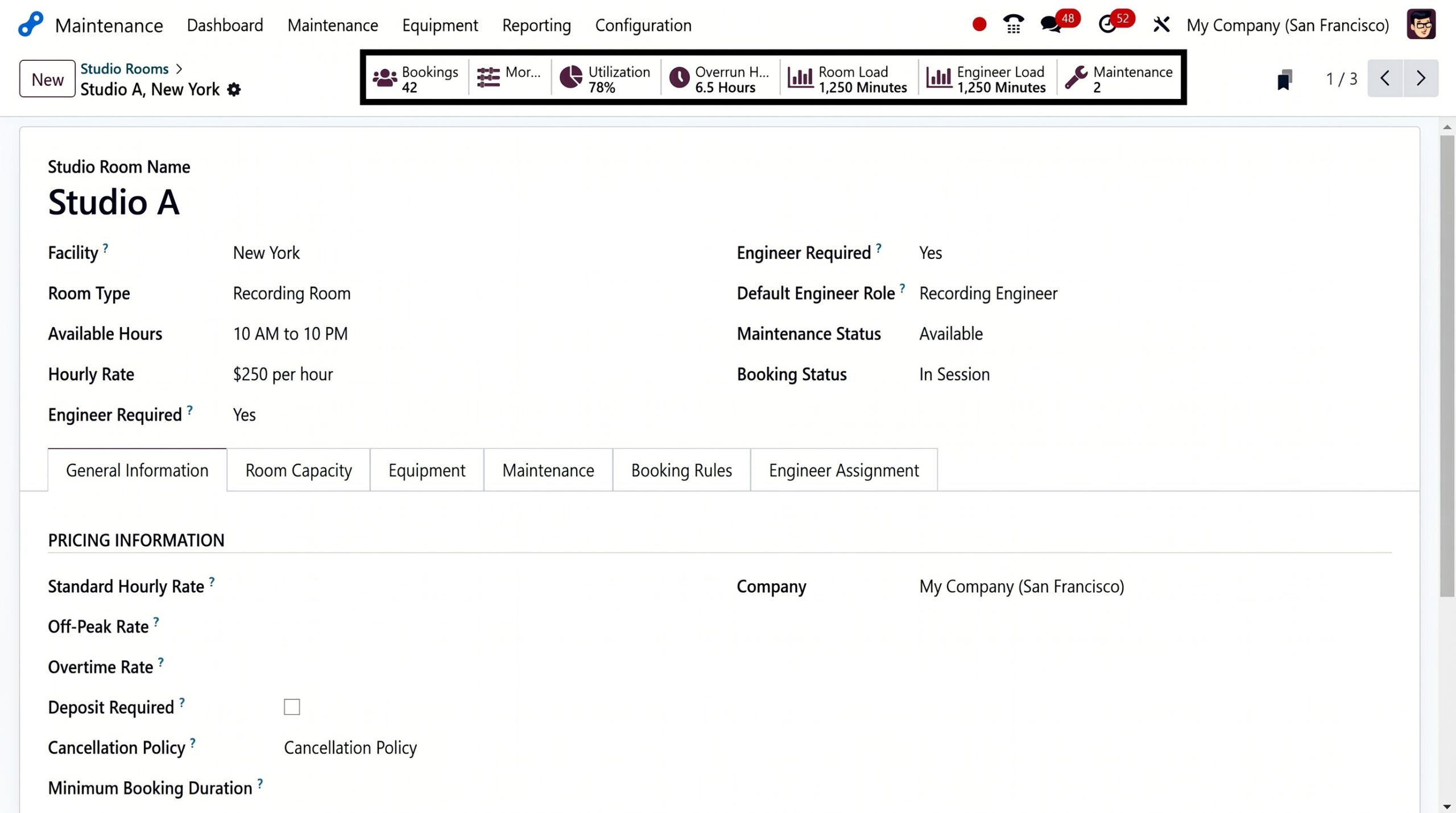

Each room record captures facility, room type, available hours, hourly rate, engineer requirements, default engineer role, maintenance status, and booking status. Smart buttons surface live metrics, and tabs for Room Capacity, Equipment, Maintenance, Booking Rules, and Engineer Assignment give coordinators full control over room level policies without custom code.

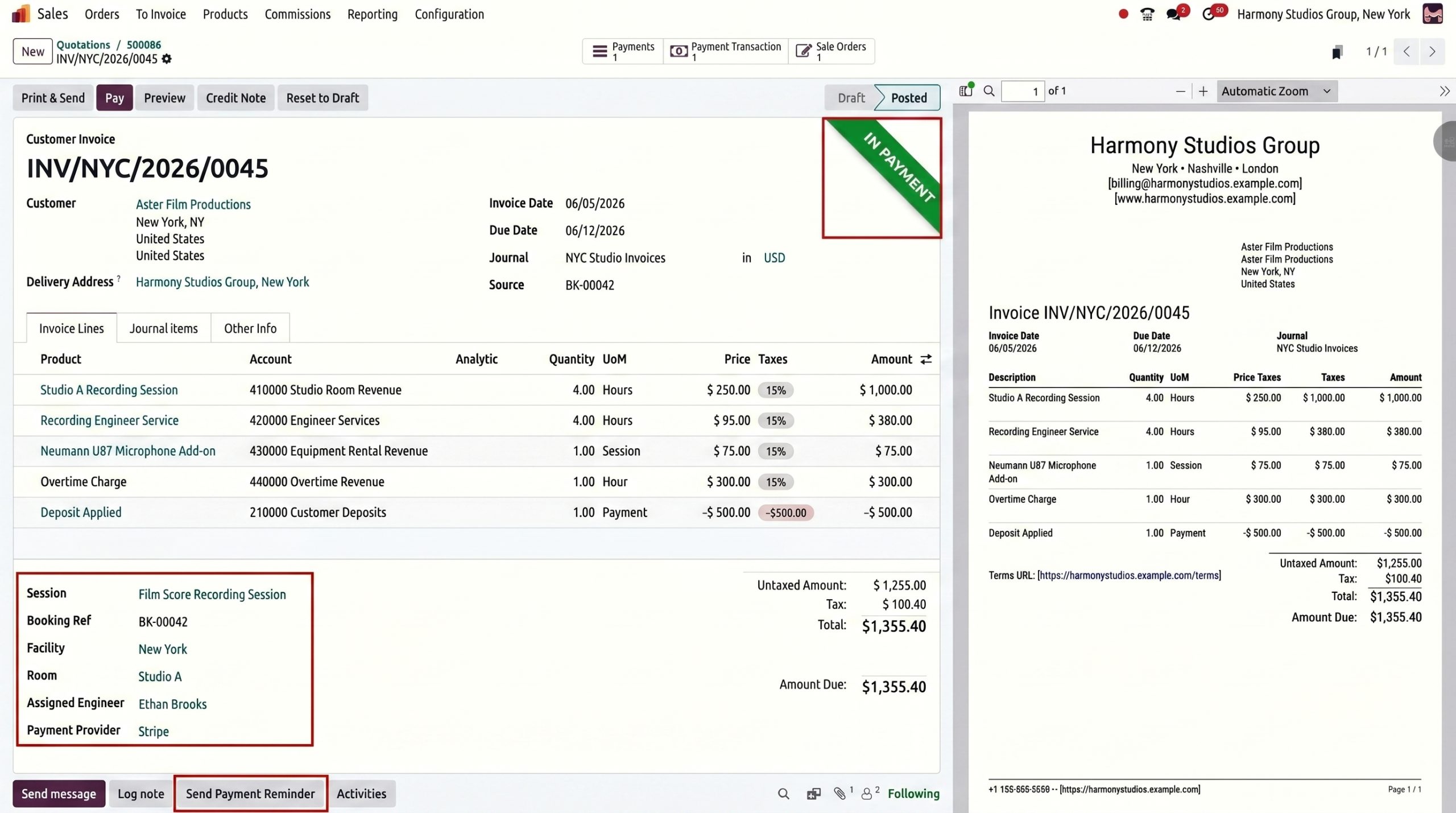

Each invoice generates directly from its booking. Line items break down room hours, engineer hours, equipment add ons, and overtime, with the deposit credit applied automatically. A callout panel links the invoice to its source session, facility, room, assigned engineer, and payment provider.

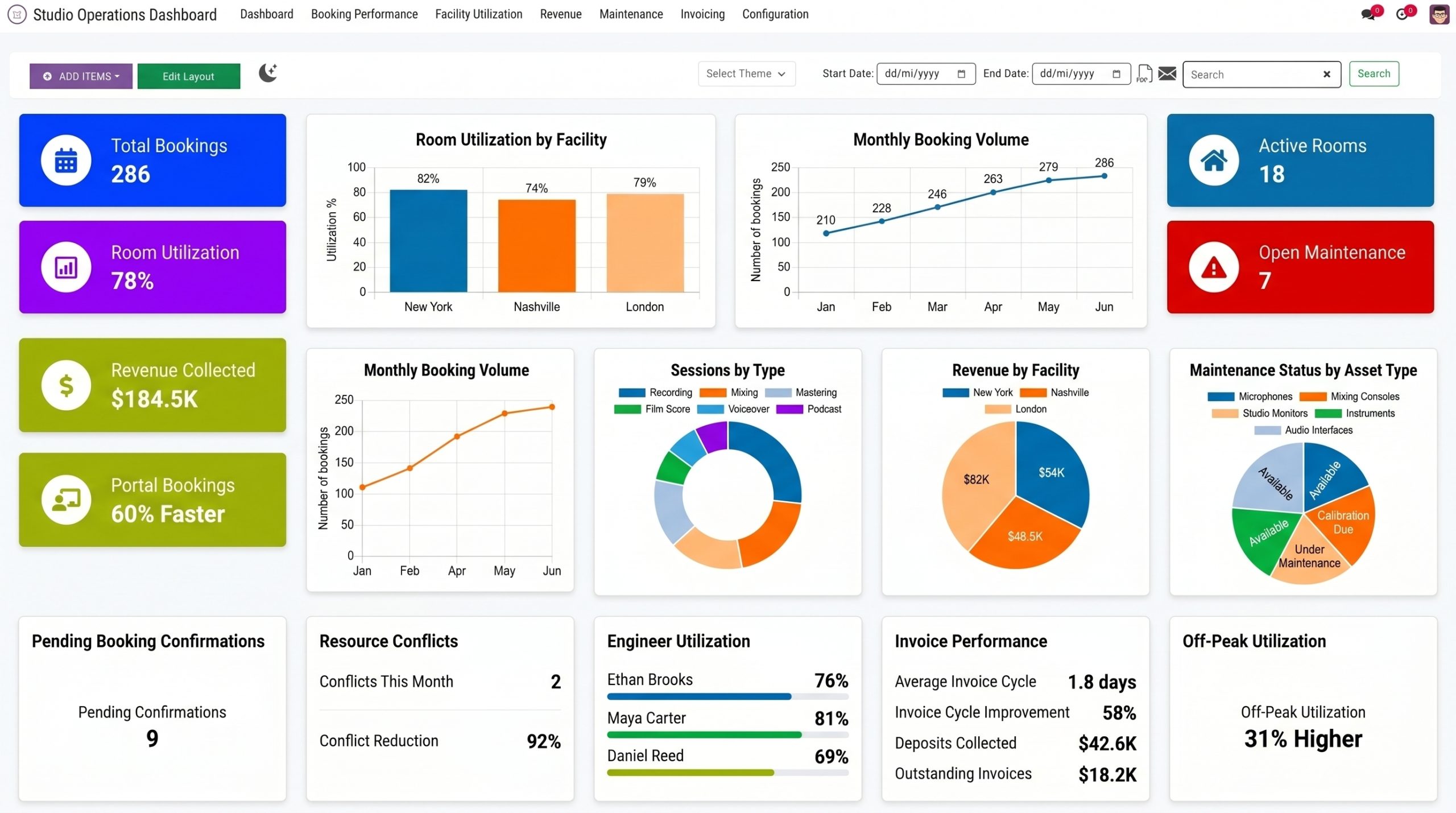

The executive dashboard consolidates every headline metric: total bookings, room utilization, revenue collected, and faster portal bookings. Room utilization by facility and monthly booking volume trend upward, alongside conflict reduction, invoice cycle improvement, off peak utilization, and individual engineer load.

The assignment method enforces resource first booking: coordinators select the engineer and room before choosing a time slot, preventing scheduling conflicts at the point of entry. Tiered reminders (artist at 24 hours, engineer at 12 hours, session at 1 hour) reduced no shows and late arrivals across all facilities.
XML and QWeb templates extended the portal interface, displaying session histories, deposits, and payment receipts. User roles consolidated with record rules and access control lists, securing over 70 concurrent users across departments. Third party integrations supported real world operations: Stripe Connect handled secure card payments, Twilio SMS managed real time reminders, and the Google Calendar API provided read only synchronization for engineer visibility. The client maintained a separate marketing platform by choice, so a one directional Zapier bridge fed new booking contacts into the external CRM for lead segmentation without pulling marketing concerns into the booking system. Custom Python connectors synchronized asset data with the external inventory audit tool, keeping Odoo the single source of truth.
Delivery followed a scrum cadence with two week sprints producing demonstrable increments: booking constraint logic in Sprint 2, deposit and pricing policies in Sprint 3, and maintenance aware availability in Sprint 4. Each sprint closed with UAT sessions attended by front desk, engineering leads, and finance. On Odoo.sh, the team maintained development, staging, and production branches with gated deployments, and automated tests validated booking intersection rules, deposit application, and invoice creation.
The team instrumented server actions and key workflows with concise logs to aid triage during hypercare. Alerting surfaced booking failures caused by missing resources, payment timeouts, or conflicting overrides. Daily dashboards summarized exception rates and reconciliation latency, giving managers early warning when policy exceptions rose above baseline. Performance budgets guided configuration, since availability searches spanned thousands of calendar entries across rooms and engineers, so indexes and filtered queries required careful tuning. During UAT, a soundtrack production exposed an edge case where a shared engineer was needed in overlapping rooms, so the team introduced a subtask model inside each session record that allowed partial engineer assignment without breaking billing integrity. A second edge case appeared when an equipment service window overlapped a late night session, so the team added a guided substitution flow that presented approved alternates ranked by availability and recorded the substitution on the booking for auditability.

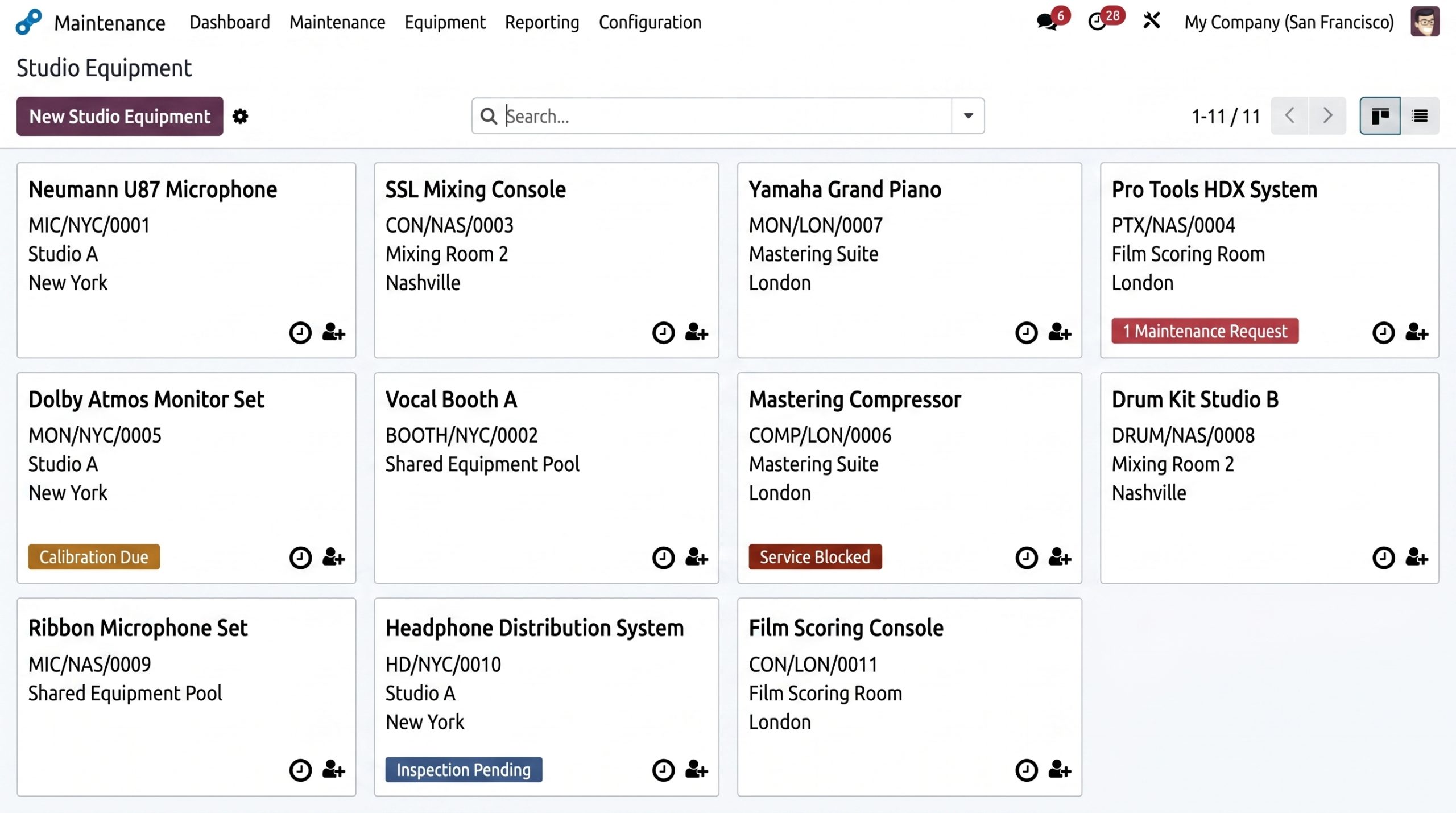

Equipment items are tracked across New York, Nashville, and London with location coded identifiers. Maintenance badges surface at the card level, so coordinators see equipment readiness alongside room and engineer availability before confirming any booking.

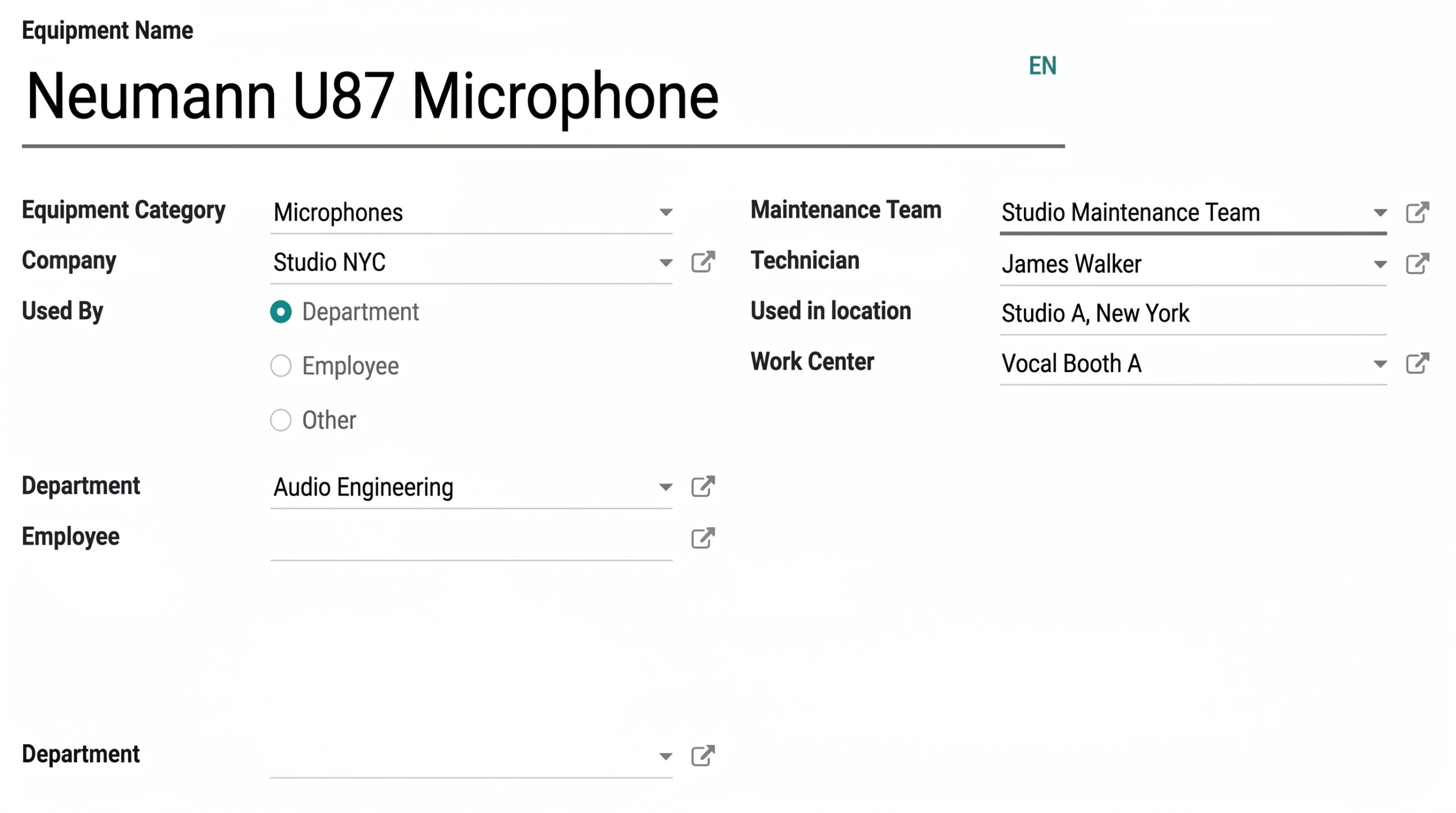

Each piece of equipment binds to a specific company, location, work center, department, and maintenance team with an assigned technician. This linkage ensures maintenance events propagate to the correct booking calendars and that substitution recommendations draw from the same facility pool.

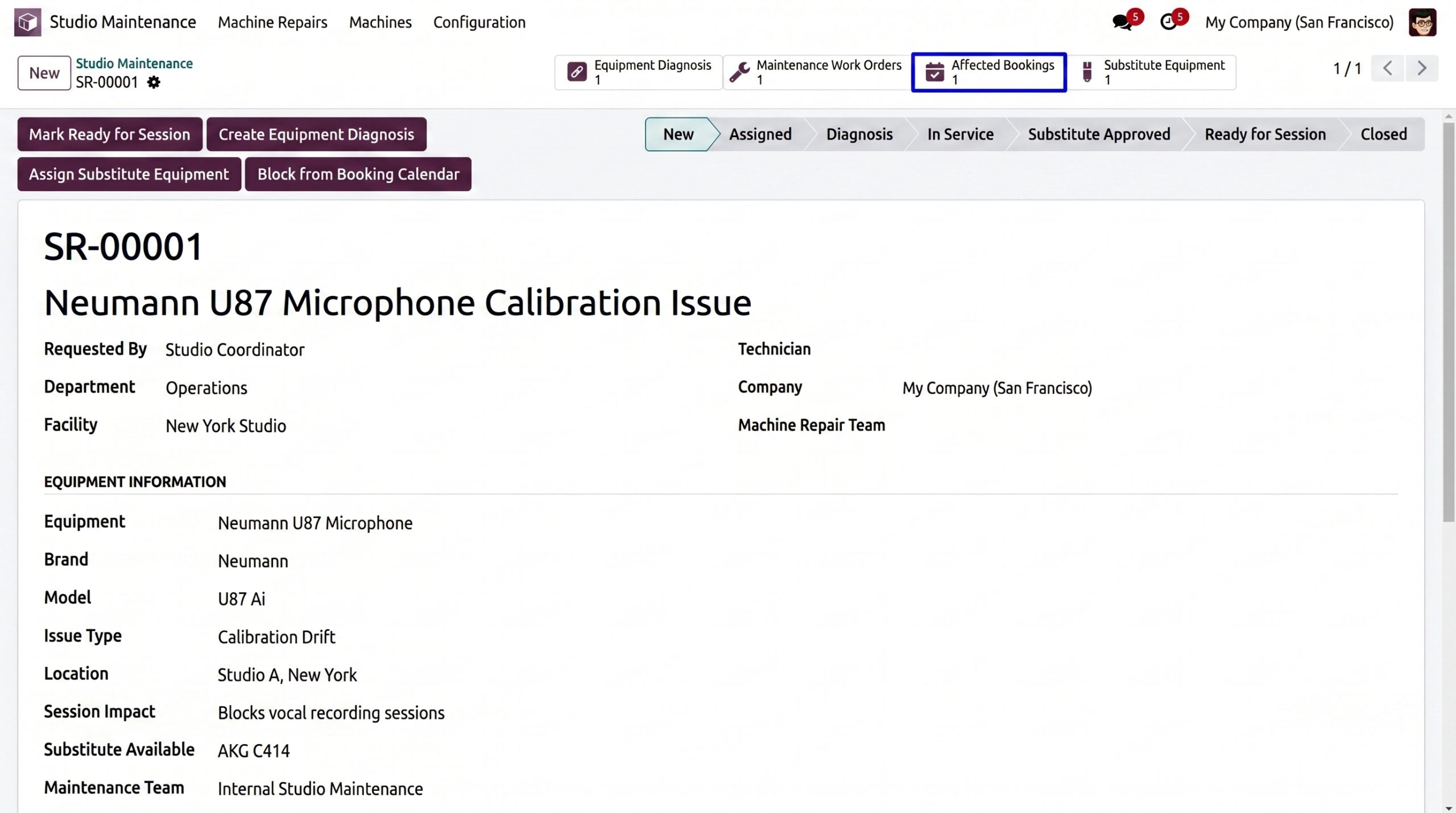

A maintenance record shows the full lifecycle from new through diagnosis, substitute approved, and ready for session. Smart buttons link to affected bookings, substitute equipment, and maintenance work orders, and a session impact field connects maintenance directly to booking logic.

Equipment items are tracked across New York, Nashville, and London with location coded identifiers. Maintenance badges surface at the card level, so coordinators see equipment readiness alongside room and engineer availability before confirming any booking.

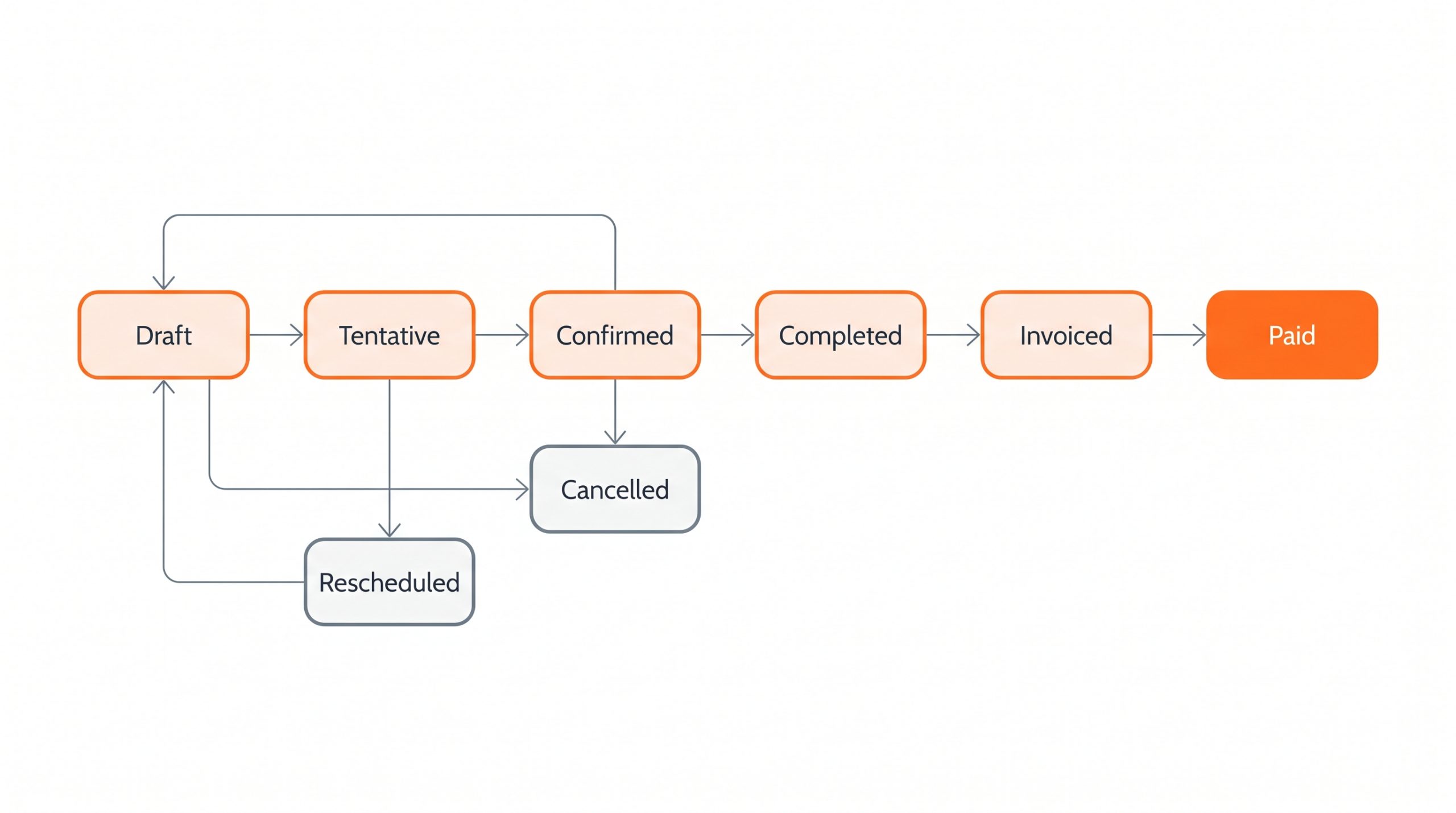

Fig 4 — Session Lifecycle State Machine
Finance discussions centered on deposit policy, where ad hoc waivers skewed aging reports. The team implemented structured deposit reasons and approver roles, so each waiver recorded a reason code and dashboards showed waiver trends, turning goodwill into measurable policy. Data migration became an alignment exercise, since room names, equipment identifiers, and client categories differed by site, so the team consolidated taxonomies, ran test imports, and verified results with staff before go live.
The constraint model shifted responsibility for readiness from staff coordination to system logic. Rooms, engineers, and equipment became first class resources bound by availability intersections, external calendar sync remained read only, and maintenance status suppressed items until cleared. High concurrency scheduling benefited from explicit indexes on date range queries and lean domain filters. Enablement focused on user autonomy: artists handled most tasks through the portal, engineers received early training and retained controlled override rights, and front desk staff practiced exception handling through brief SOPs accessible beside the relevant screens.

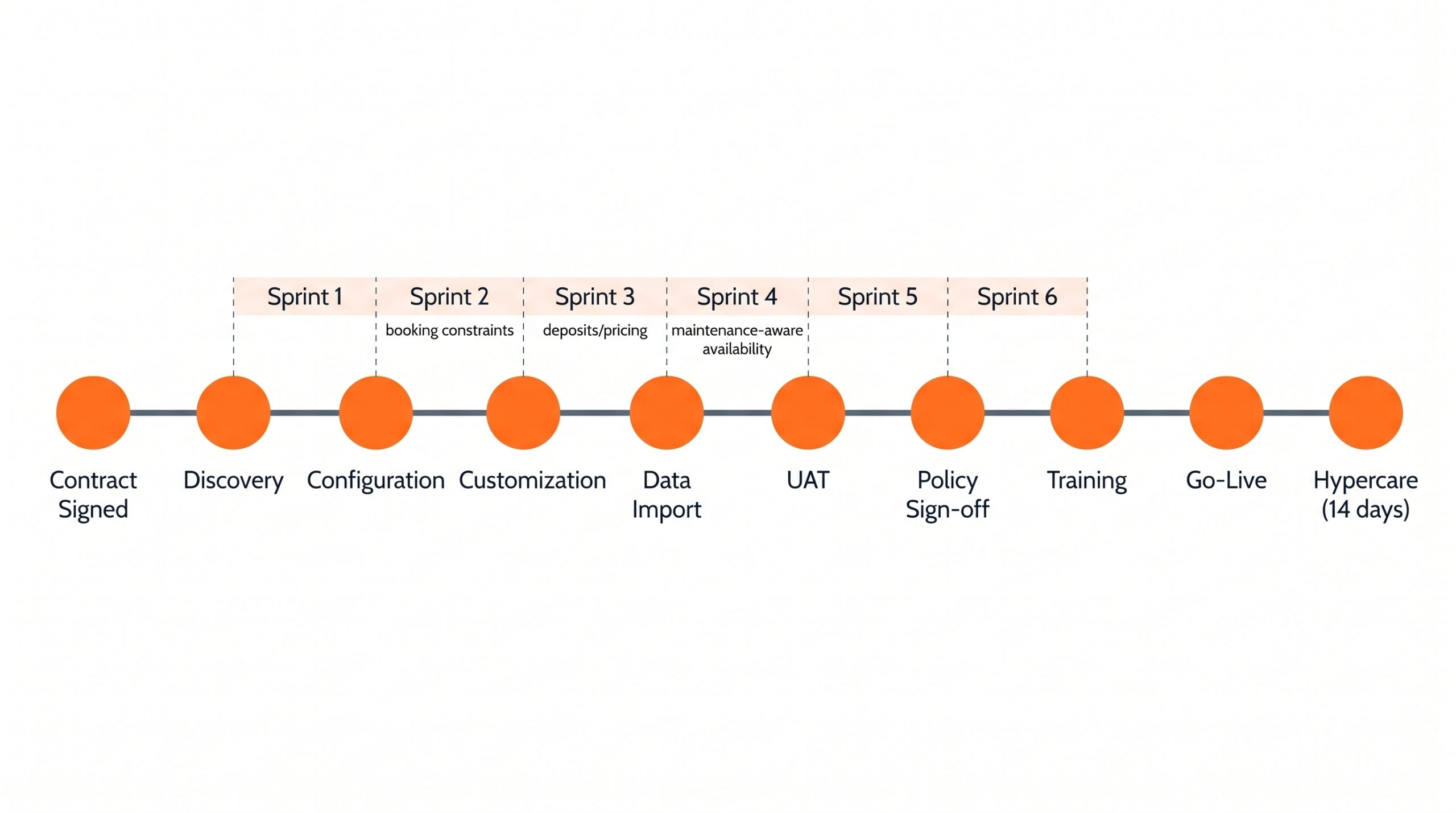

Fig 5 — Implementation Delivery Timeline
Adoption followed a practical curve. In week one, portal bookings accounted for 28% of sessions; by week six, the share crossed 60% as artists discovered self service rescheduling and receipts. Finance reported the first month end close finished two days earlier than baseline with fewer manual adjustments, and front desk email volume related to availability dropped by roughly one third.
The Odoo platform unified scheduling and revenue operations across all studios. Booking confirmation time decreased 66%, scheduling conflicts fell 92%, and off peak utilization improved 31%. Automated billing reduced invoice turnaround 58%, and reconciliation became same day. Artists gained transparency to manage bookings and receipts independently, while managers viewed utilization, waiver frequency, and revenue in real time.

Constraint based validation replaced manual cross checking of rooms, engineers, and equipment across facilities.

System enforced availability intersections eliminated double bookings and resource collisions.

Structured discounting and real time availability surfaced unused capacity to artists.

Automated billing from booking data reduced invoice turnaround and enabled same day reconciliation.

Artists handled bookings, rescheduling, and receipts independently within six weeks of launch.

Automated deposit tracking and waiver logging reduced manual adjustments at period end.
“Artists appreciated being able to manage bookings, receipts, and rescheduling on their own. It reduced back and forth and made the experience feel more professional.”
~ Artist Relations Manager
“The schedule finally matched how the day really works. If a room, engineer, or key piece of gear was not available, the system caught it before it became a problem.”
~ Senior Engineer
Platform: Odoo 17 Enterprise, Odoo.sh hosting
Configuration and Customization: Odoo Studio, custom Python modules, QWeb and XML templates
Odoo Modules: Website, Appointments, Inventory, Maintenance, HR, Project, Timesheets, Sales, Accounting, Rentals
Payments: Stripe Connect
Notifications: Twilio SMS Gateway
Calendar Sync: Google Calendar API (read only)
Integration: Zapier, custom Python connectors
Access Control: multi company configuration, record rules, access control lists
